ALTA Survey Timing: When Commercial Buyers Should Order One

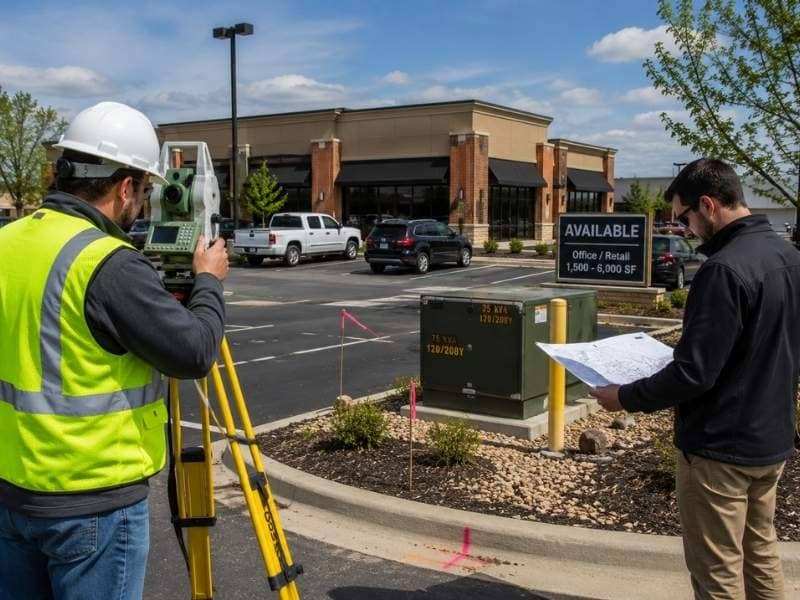

ALTA survey in progress at a commercial property with a surveyor collecting boundary and site improvement data before a real estate purchase.

Most deals don’t fall apart because of a bad survey. They stalled because someone ordered the ALTA survey three weeks before closing, then acted shocked when the boundary didn’t match the deed. The survey sits right in the middle of almost every commercial purchase. Buyers who treat it as a last-minute task end up asking for an extension they never needed.

Order it early. That’s the short version. The rest of this explains why the clock runs the way it does.

When should a buyer order an ALTA survey?

Order it in the first week of due diligence, right next to the title work and the environmental report. The survey needs record research, fieldwork, drafting and at least one round of review. Any one of those steps can turn up a question that takes days to sort out.

Ordering early won’t make the drafting faster. It buys you room at the end, which is where buyers always run short. Say the surveyor finds a fence crossing the line or a gap in the legal description. Someone has to decide what to do about it. That talk goes much better with four weeks left than with four days.

The title commitment matters here too. A surveyor can start research and even send a crew out without it. But the finished survey has to line up with the title exceptions. So the order goes like this: order title, order survey, then send the commitment to the surveyor the moment it lands.

What happens between the order and the delivery?

An ALTA survey isn’t just a site visit with a drawing at the end. The work breaks into four parts, and each one has its own delays.

Research comes first. The surveyor pulls the title commitment, the legal description, recorded plats, easement papers and any old surveys, then compares them. Missing or conflicting records stretch this step more than anything else.

Fieldwork comes next. A crew locates the boundary, finds or sets markers, and maps the improvements the standards require.

Then the surveyor drafts the map and works out what the field data says against what the records claim. Those two rarely agree.

Review wraps it up. The buyer, the lender and the title company all read the draft, and any of them can send it back. One forgotten Table A item can send the crew back to the site.

Hand over your records at the start. Research is the only step you actually control.

What makes a survey take longer?

Some properties simply take more work. Expect a longer schedule when the site has any of these:

  • Large acreage or an odd shape
  • Missing or damaged boundary markers
  • Thick brush, standing water or blocked access
  • Lots of easements, utilities and buildings
  • An old legal description that doesn’t close cleanly
  • Several parcels joined into one description
  • A tenant who limits when a crew can work

Access trips up more buyers than anything else on that list. A surveyor who can’t get on the property can’t finish the job. If the seller controls the gate, or a tenant needs notice, handle it before the crew schedules the trip.

Old descriptions cause another big delay. A boundary written a hundred years ago may force the surveyor to research neighboring deeds and rebuild the line from evidence. That work doesn’t speed up just because closing is near.

Why do Table A items need to be settled early?

The 2021 ALTA/NSPS standards include a list of optional items called Table A. The buyer, the lender and the title company pick which ones they want. Those picks set the scope, and the scope sets the schedule.

Common ones cover land area, contours, building sizes, parking counts, zoning setbacks and utility locations. Each one costs real field hours or research time. Utility items often need coordination with the utility owners, which drops a third party into your timeline.

Late Table A requests are the easiest delay to avoid in this whole process. When a lender decides in week five that they want contours after all, the crew goes back out. So get the lender’s survey requirements in writing before fieldwork starts, and make sure the title company agrees with the list.

A clear scope also gets you a delivery date the surveyor can stand behind. Fuzzy scopes get you fuzzy estimates.

How does the survey fit with the rest of due diligence?

The survey feeds other work, so its spot in the schedule affects more than the survey itself.

The title company reads it against the exceptions in the commitment. That comparison is what creates survey-related title objections. Push the survey late and you squeeze the time left to raise them.

Engineers and architects use the survey as the base drawing for early planning. A survey that shows up two weeks late pushes their work back two weeks. Environmental firms may need boundary and easement details as well.

Ask the lender, the title company and the design team what they need and when they need it, then work backward from closing. A team that spots a missing easement document in week two still has choices. The same team finding it in week seven is drafting an extension.

Frequently Asked Questions

How long does an ALTA survey take?

Plan on anywhere from a couple of weeks to a couple of months. Size, record quality, site access, boundary problems, Table A picks and the surveyor’s current workload all move that number. Nobody can quote you a firm date without reading the title commitment and the legal description first, so treat any estimate given before that as a rough guess.

What documents does the surveyor need to start?

Send the current title commitment with all the exception documents attached, the legal description, any old surveys, recorded plats and written instructions covering the Table A items. Buyers often send the commitment but leave out the actual easement papers, which stops the research cold. Send the documents themselves, not just the list.

Can added Table A items change the schedule?

Yes, and sometimes by a lot. Items covering utilities, contours, zoning or detailed building measurements add field hours, research or outside coordination. A request made after the crew leaves usually means another trip to the site. Lock the list before fieldwork begins.

Can we reuse an older ALTA survey?

An old survey gives the new surveyor useful background, but it rarely satisfies a lender or title company by itself. Conditions change, standards get updated, new exceptions get recorded, and the old certification names people who aren’t part of your deal. Most transactions call for a new survey or an update from a licensed surveyor.

Can fieldwork start before the title commitment arrives?

Early research and some field measurement can move ahead, and surveyors often start that way when closing is tight. The survey still can’t be finished or certified without the commitment and its exception documents. Plotting those easements against the boundary is a core part of the standards.

Topographic Survey Data Engineers Need Before Grading Starts

Topographic survey crew collecting elevation and drainage data on a construction site before grading starts for accurate engineering design.

Grading plans fail for boring reasons. Somebody designed a slope against elevations that were guessed instead of measured. Somebody forgot the retaining wall sitting right where the new grade needs to fall. A topographic survey exists to prevent exactly that, and the quality of the survey sets the ceiling on the quality of the grading design.

The pattern is consistent across projects. Weak field data doesn’t fail during design. It fails during construction, when the contractor discovers the dirt doesn’t balance and the change orders start.

What ground elevation data does a grading design require?

A topographic survey records measured elevations across the site, usually shown as contour lines and spot elevations. Contours connect points of equal height. Spot elevations pin the exact height at a specific location, which matters at pavement edges, structure corners and anywhere the design gets tight.

Density is the thing people underestimate. A survey with too few points smooths over the ground and hides the features an engineer actually needs. Slopes, ridges, low spots and abrupt grade breaks all have to appear in the data, because the earthwork calculation depends on them. Cut and fill volumes shift substantially when the surface model misses a swale or a hump.

So the shot density should match the terrain, not a template. Flat parking areas tolerate a wider grid. Rolling ground, steep banks and irregular sites demand tighter coverage.

Which site features affect grading beyond elevations?

Elevations alone won’t produce a workable grading plan. The survey has to map the physical constraints that limit where and how far a designer can move dirt.

Those constraints usually include:

  • Buildings, walls and foundations
  • Roads, curbs, gutters and pavement edges
  • Fences, driveways and site walls
  • Ditches, swales and culverts
  • Trees worth preserving
  • Visible utility structures, poles, meters and vaults

Each of these can pin a grade in place. A retaining wall fixes an elevation. A neighboring driveway sets a tie-in point. A protected tree limits how much soil the contractor can strip near the root zone.

The project scope should name these features explicitly before the crew mobilizes. Vague scopes produce vague surveys, and a second site visit costs more than a clear conversation would have.

Why does survey control matter so much?

Control gives the survey a known horizontal position and a known vertical reference. Without it, every elevation on the drawing floats. The numbers might look internally consistent and still sit two feet off the datum the contractor uses.

The surveyor should state the datum plainly on the drawing. Vertical datums differ, and mixing NAVD88 with an assumed local elevation creates errors that nobody catches until concrete gets poured.

Benchmarks belong on the plan too. The construction crew needs a physical point they can shoot from during grading, ideally one that won’t get destroyed by the first bulldozer through the site. Set it outside the work area.

When the engineer, the surveyor and the contractor all reference the same control, elevation disputes mostly disappear. When they don’t, somebody eventually rebuilds a pad at their own expense.

How does a topographic survey inform drainage design?

Water reads the surface, so the surface data has to be right. Field crews capture existing swales, ditch flowlines, culvert inverts, inlets, pipe rims and creek banks, because those points define how the site drains today.

Inverts deserve special attention. A pipe rim elevation tells the engineer almost nothing about capacity or slope. The invert tells them everything. Missing invert data forces assumptions, and assumed pipe slopes have a way of producing storm systems that don’t actually flow.

One limitation is worth stating plainly. A survey captures conditions on the day the crew worked the site. A blocked culvert, a dry ditch during drought, or seasonal high water can all misrepresent normal behavior, so field observations should be paired with rainfall data and drainage records rather than treated as the complete picture.

What digital files should the engineer receive?

A printed drawing won’t support a grading model. Engineers need survey data in a form their design software can actually consume, and this is where projects lose time when nobody discusses it upfront.

The deliverable usually includes:

  • A CAD file with layered linework
  • A raw point file with descriptions
  • Contour data at an agreed interval
  • Breaklines along grade breaks, ditch bottoms, curbs and walls
  • A digital terrain or surface model

Breaklines carry more weight than most people realize. They force the surface model to respect sharp changes in the ground instead of smoothing a curb into a gentle ramp. A surface built from points alone will misrepresent every hard edge on the site.

Agree on the file format, coordinate system, units and contour interval before fieldwork begins. That single conversation prevents most of the rework that shows up later, when the engineer imports the data and discovers the survey came in a coordinate system nobody else uses.

Frequently Asked Questions

What does a topographic survey include?

The survey typically covers ground elevations, contours, buildings, pavement, drainage features, visible utilities, trees, walls and any other feature the project scope names. The scope drives everything, so a survey ordered for a small addition looks very different from one ordered for a full site development. Engineers who list their requirements clearly get usable data on the first visit.

Why do engineers need a topographic survey before grading?

The survey supplies the measured ground data behind every slope, drainage path, cut area and fill area in the design. Without it, earthwork quantities become guesses, and guessed quantities turn into change orders once the contractor starts moving dirt. Accurate existing conditions also protect the engineer when a dispute arises over site changes.

How do you choose a contour interval?

The interval is the vertical distance between contour lines, and the right choice depends on terrain and design tolerance. Flat sites often need a one foot or even half foot interval to reveal meaningful slope, while steep or rough ground reads fine at two feet or more. Set the interval during scoping rather than after the crew has already collected the data.

Can a drone collect topographic survey data?

Drones handle open, clear sites well and cover large areas quickly. Vegetation is the limiting factor, since photogrammetry maps the top of grass and brush instead of the ground beneath it. Ground control, field verification and the project accuracy requirements all still apply, and dense tree cover usually calls for conventional ground methods or lidar.

Does a topographic survey show underground utilities?

It shows visible surface features and any utility marks included in the scope, such as manholes, valve boxes and local paint. It cannot confirm the depth, size or exact path of buried lines without records research, a private utility locate or actual excavation. Treat mapped utilities as approximate until someone verifies them in the field.

Residential Land Survey Problems That Show Up After a Property Is Inherited

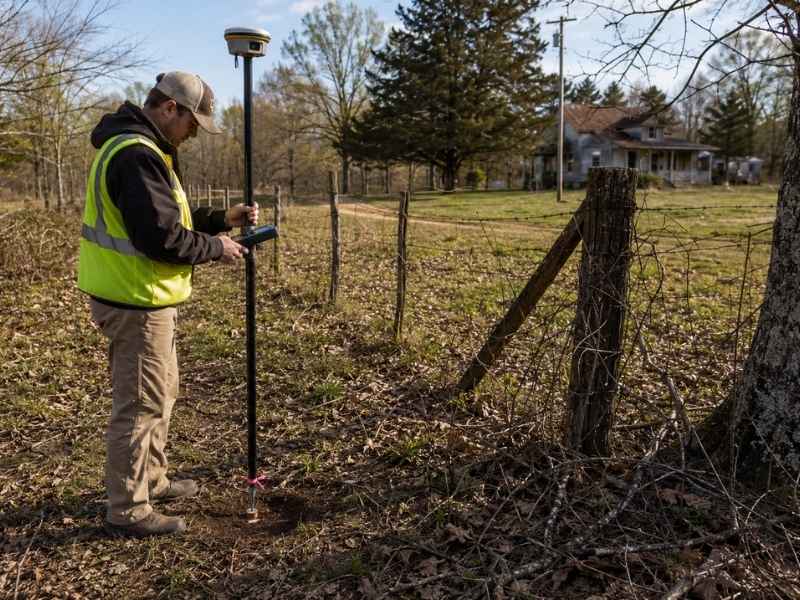

 Residential land survey in progress on inherited rural property with a surveyor locating a boundary marker near an old fence and farmhouse.

Nobody inherits a survey. People inherit land, a folder of yellowed papers and a lot of family certainty about where the property ends. A residential land survey on inherited property tends to expose the gap between those two things fast. Fences sit in the wrong place. Easements nobody mentioned run straight through the back field. Corner markers vanished decades ago.

The pattern holds almost everywhere. The longer land stays in one family, the more the paperwork and the ground drift apart. A survey closes that gap before it becomes a lawsuit, a stalled sale or a house built three feet over a line.

Why do old records make a residential land survey harder?

Inherited parcels often carry deeds written decades or even centuries ago, and those descriptions lean on landmarks that no longer exist. A residential land survey begins with record research, so missing plats and vague legal descriptions add hours before anyone sets foot on the property.

Rural descriptions cause the worst headaches. They reference a big oak, a fence post or “the old Miller place.” The oak fell in a storm. The fence rotted. The Millers sold out and left two counties over. Surveyors rebuild these lines by pulling neighboring deeds, older plats and whatever the county recorder still holds.

Heirs can cut real time off the job by gathering documents first. Useful items include:

  • Deeds, wills and probate records
  • Old plats or subdivision maps
  • Past survey drawings, even faded ones
  • Tax notices showing acreage
  • Utility or right-of-way agreements

Even a grandparent’s pencil sketch helps. It can point a crew toward evidence they would otherwise spend two days hunting.

Why don’t family boundary lines match the deed?

Long use doesn’t move a written boundary. Families treat fences, tree lines and creeks as property markers, but those features rarely sit on the deed line. A residential land survey measures the record, and the record wins.

This surprises almost nobody in the profession. Land that passes through a will skips the one event that normally forces a survey. A sale brings in a lender, a title company and a fresh drawing. A funeral brings none of that.

So the crew regularly finds a fence several feet off. Driveways drift onto a neighbor’s parcel. A shed from 1978 sits right on top of a corner nobody ever checked. Adverse possession law complicates matters further, because decades of open, uninterrupted use can create a real legal claim in many states. The time period varies widely, so the family attorney reads that one, not the surveyor.

A survey won’t settle who owns what. It hands the family accurate facts and lets the lawyers work from there.

What easements show up on inherited land?

An easement gives someone else the legal right to use part of your land for a set purpose, and inherited parcels hide them constantly. A grandfather signed a utility agreement in 1958 and nobody has mentioned it since. A residential land survey shows recorded easements when the documents surface, along with visible signs of use out in the field.

Common ones include:

  • Utility lines, poles and buried cable
  • Shared driveways serving a landlocked parcel behind you
  • Drainage ditches and stormwater paths
  • Pipeline corridors and rights of way
  • Access roads granted to a neighbor generations back

Crews notice the physical clues too. Truck ruts across a hayfield, a buried pipe marker or a cleared strip through the woods usually means something is recorded somewhere.

These rights start to matter the moment heirs make plans. An easement can kill a house site, block a driveway or shrink the usable acreage right before a sale. Hand your surveyor the title work and any old agreements you turn up, because that paperwork decides what ends up on the map.

Why does rural acreage take longer to survey?

Country land takes longer because the crew covers more ground under worse conditions. Briars, creek crossings, steep slopes and grown-over logging roads all slow fieldwork, and a family parcel might run 40 acres instead of a quarter acre.

A crew can spend most of a day locating a single original corner. Iron pipes sink. Stones roll downhill. Trees swallow them whole.

Older parcels bring a second problem. Whoever wrote the original description worked with a chain and a compass, so those old numbers rarely close cleanly against modern measurements. The surveyor then reconciles neighboring deeds and older plats until the pieces fit together.

Owners can speed this up. Cut a safe path where you can, and share what you remember. If an uncle knows where the corner stone once sat, say so before the crew starts searching.

What can heirs do once the survey is finished?

A current residential land survey gives every heir one accurate picture of the same property. Boundaries, buildings, access points and easements all appear on a single drawing, which unlocks nearly every decision the family faces next.

That drawing earns its cost quickly. Buyers ask for it. Lenders ask for it. Builders want it before they place a house or cut a driveway. And a family splitting land three ways can’t divide anything fairly until they know exactly what they’re dividing.

It also cools arguments down. Memory makes a terrible surveyor. Once everyone reads the same map, the conversation shifts from what Dad always said toward what the record actually shows.

Match the survey type to the plan, though. A boundary survey answers a different question than a survey prepared for a land division, so explain what you intend to do with the property before fieldwork begins. Only a licensed surveyor can certify a boundary, and every state regulates the profession for exactly that reason.

Frequently Asked Questions

Do heirs need a survey right after inheriting land?

Usually yes, especially when the paperwork looks thin or the family plans to sell, build or divide. Anyone holding the land untouched, with clean records and no close neighbors, can reasonably wait.

Can we still use a survey from 30 years ago?

Treat it as a head start rather than an answer. Markers disappear, neighbors build, utility companies move in and most lenders will reject a drawing that old.

Will a survey catch every easement?

It captures whatever the records reveal plus whatever the crew can see outdoors. An unrecorded handshake deal from 1970 stays invisible, which is why title research runs alongside the fieldwork.

What happens when the corners are gone?

The surveyor rebuilds the line using deeds, adjoining surveys, surviving monuments and physical evidence left on the ground, then sets fresh markers you can actually find.

Why does country property cost more to survey?

Hours. Large acreage, heavy brush, rough terrain and unreliable old paperwork all stack up. A tight platted lot with clean records simply takes less field time.
